A Gantt chart is one of the most powerful tools in a project manager’s arsenal. It provides a visual timeline of tasks, allowing teams to track progress, dependencies, and deadlines at a single glance. While specialized software like Microsoft Project or Asana exists, you can create a highly customizable and professional Gantt chart directly within Microsoft Excel without spending an extra dime.
This comprehensive guide will walk you through the process of building a dynamic Gantt chart from scratch. We will cover everything from structuring your data correctly to using advanced formatting techniques like Error Bars to track real-time project completion.
1. Preparing Your Project Data
The foundation of any effective Excel chart is a well-structured dataset. Before attempting to visualize the timeline, you must organize your project parameters logically. A standard Gantt chart requires four specific data points: Task Name, Start Date, Duration (Days), and % Completion.
To begin, set up your spreadsheet columns. If you are tracking a complex project, accuracy in your data entry is crucial. You might want to use formulas like WORKDAY to calculate end dates automatically based on weekends and holidays.
Completed Gantt chart example in Excel showing project timeline
To visualize the actual progress (the percentage complete), we need to derive a specific metric called “Days Completed.” This is calculated based on the total duration and the percentage of work finished.
You should add a helper column to your data table. The logic is simple:
- If you are planning the baseline, the completed days might be zero.
- For actual tracking, use the formula:
Days Completed = % Completion * Days.
Animation showing how to set up the data table columns

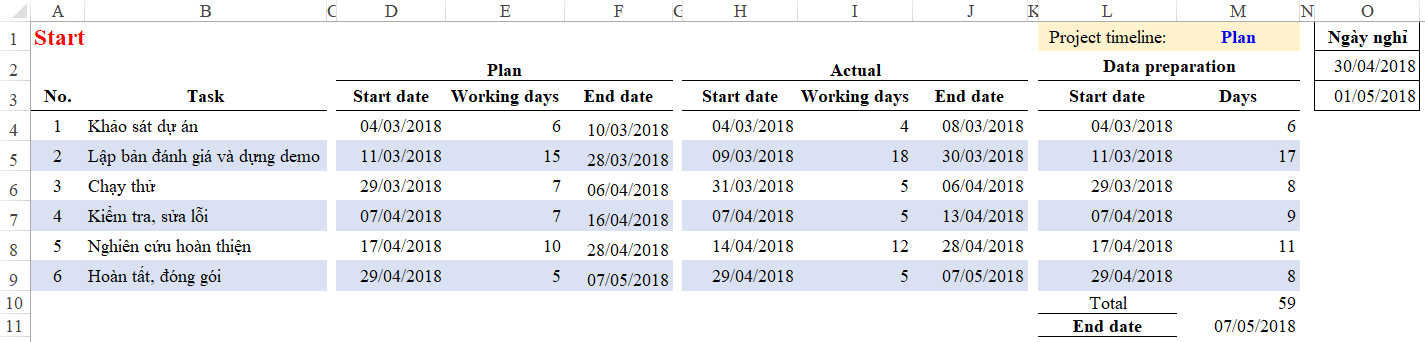

Once your formulas are set, your final data table should look clean and organized. This table acts as the source of truth for the visualization. Ensure that your dates are formatted correctly as Date types in Excel to avoid errors later in the charting process.

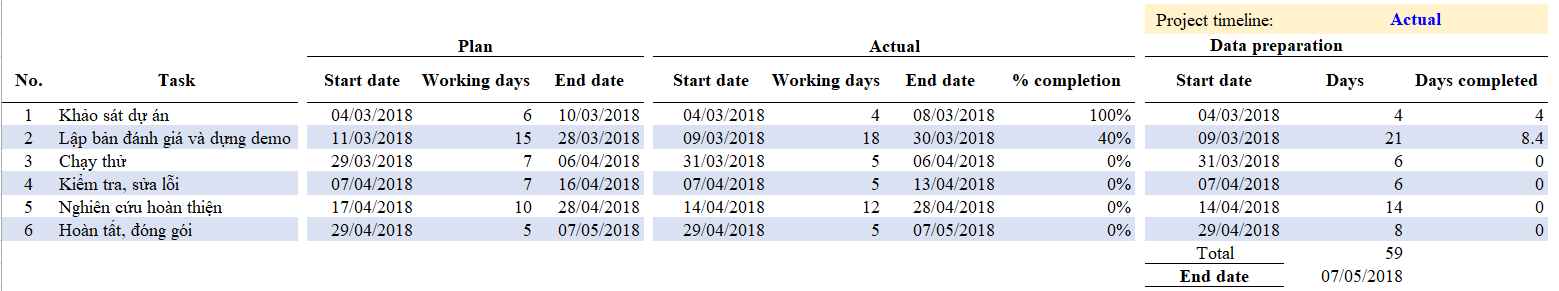

Finalized Excel data table with columns for Task, Start Date, Days, and Percentage Completion
2. Step-by-Step Guide to Drawing the Gantt Chart
Excel does not have a native “Gantt Chart” button. Instead, we utilize a Stacked Bar Chart and modify its properties to simulate the floating bars characteristic of a Gantt timeline.
2.1. Initializing the Chart

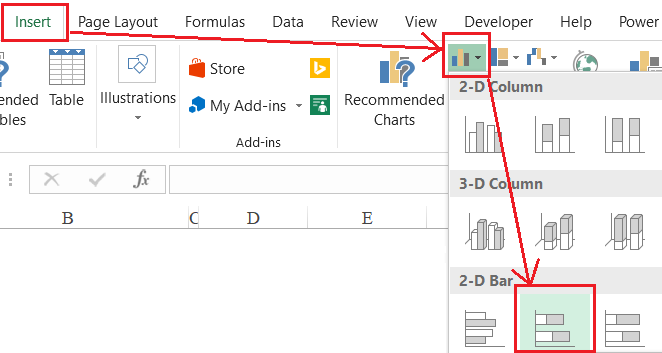

Navigate to the Insert tab on the ribbon. In the Charts group, select the Bar Chart icon and choose the Stacked Bar (2D) option. Do not select the standard Bar chart; the “Stacked” aspect is essential because it allows us to stack the “Start Date” and “Duration” to position the task bar correctly on the timeline.
Selecting the Stacked Bar Chart option from the Insert tab in Excel
2.2. Importing and Arranging Data
Initially, Excel might insert a blank canvas. You need to manually feed it the data. Go to the Chart Tools > Design tab (or simply Design in newer versions) and click on Select Data.

Clicking Select Data in the Chart Tools Design tab
In the “Chart data range” field, select your entire table. However, to get the Gantt effect, we need to treat the “Start Date” as a data series, not just labels.

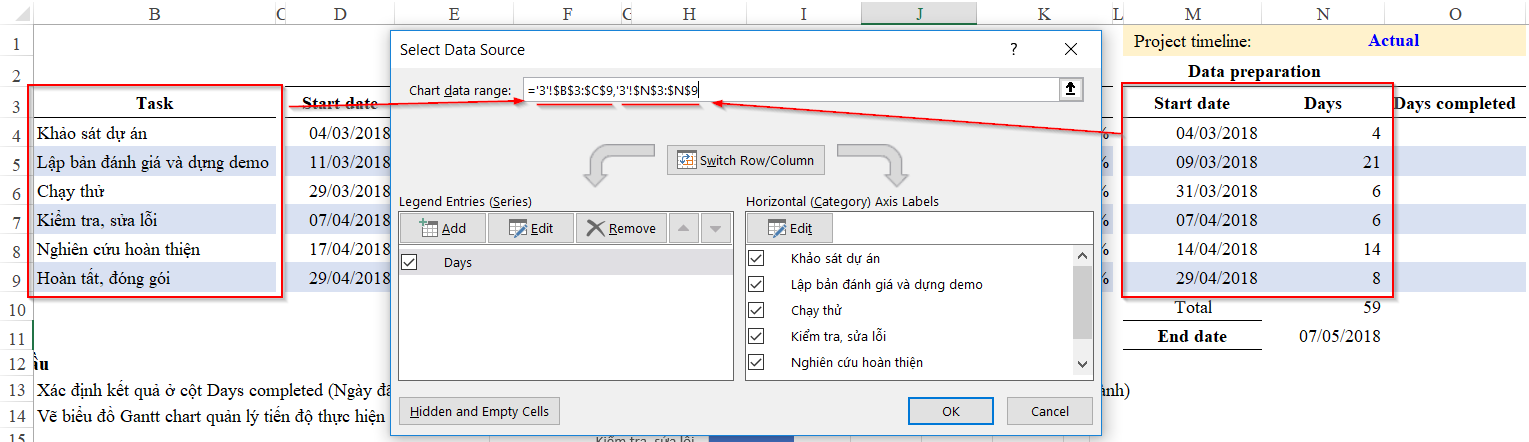

Dialog box for selecting the chart data range

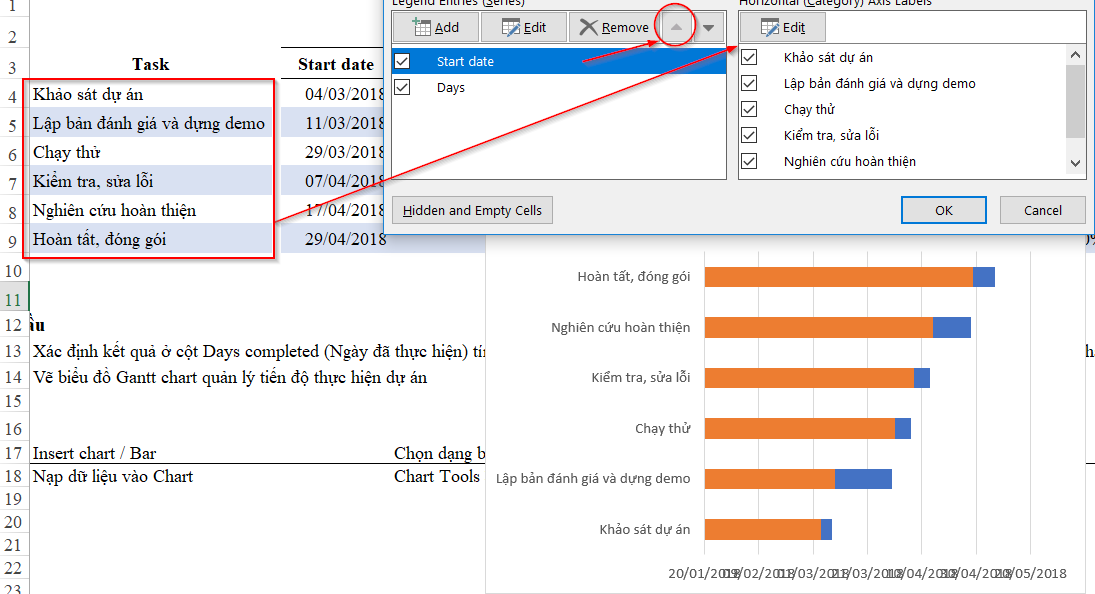

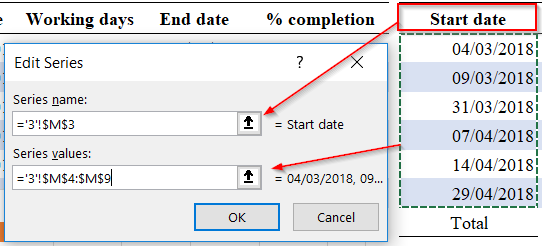

In the Legend Entries (Series) box, ensure you have added Start Date first, followed by Days (Duration). Click the “Add” button if they are not automatically populated. The order is critical: Start Date must be on top (or left) so it pushes the Duration bar to the correct starting position.
Adding the Start Date series to the chart legend entries
At this stage, your chart will look like a standard stacked bar chart with colors for both the starting date and the duration. It represents the data correctly but doesn’t look like a timeline yet.
Initial stacked bar chart appearance before formatting
2.3. Formatting the Task Order

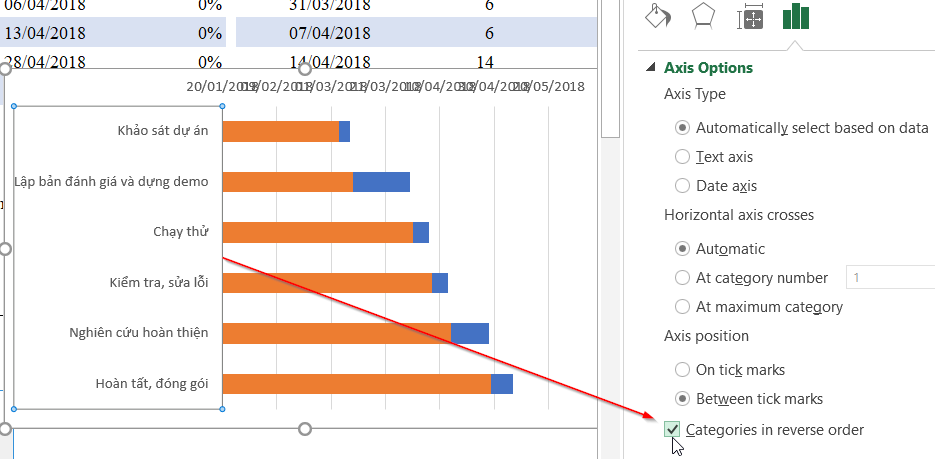

You will notice that Excel defaults to listing tasks from bottom to top (Task 1 is at the bottom). To fix this, click on the vertical axis (the task names). In the Format Axis pane, check the box labeled Categories in reverse order. This mirrors the structure of your spreadsheet.
Formatting axis options to display categories in reverse order
2.4. Creating the “Floating” Effect
This is the most critical step. We need to hide the “Start Date” bars so that only the “Duration” bars remain visible. This creates the illusion that tasks are starting at different times.

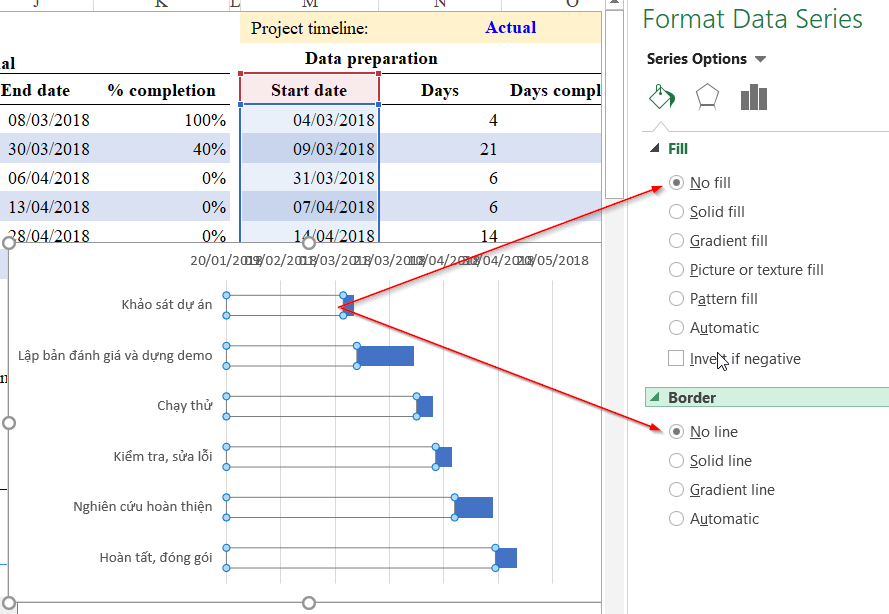

Right-click on the first series of bars (usually blue, representing Start Date) and select Format Data Series. In the Fill & Line options bucket, select No fill and No line.
Setting Shape Fill to No Fill to hide the start date bars
2.5. Adjusting the Timeline Bounds
By default, Excel might start the date axis from a random date in the past (like 1900), leaving a large empty space on the left. You need to define the Minimum and Maximum bounds for the horizontal axis.
- Find the numeric value of your project’s Start Date (Date format in Excel is actually a serial number). You can find this by copying your date to a new cell and changing the format to “General” or “Number”.
- Right-click the horizontal axis (the dates at the top) and select Format Axis.
- Enter that serial number into the Minimum bound field.

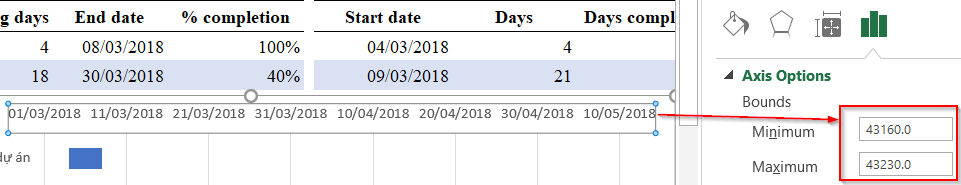

Setting minimum and maximum bounds for the horizontal axis
3. Advanced Feature: Tracking Completion Percentage
A basic Gantt chart shows the plan. A great Gantt chart shows reality. We can visualize the % Completion inside the task bars using a clever trick with Error Bars.

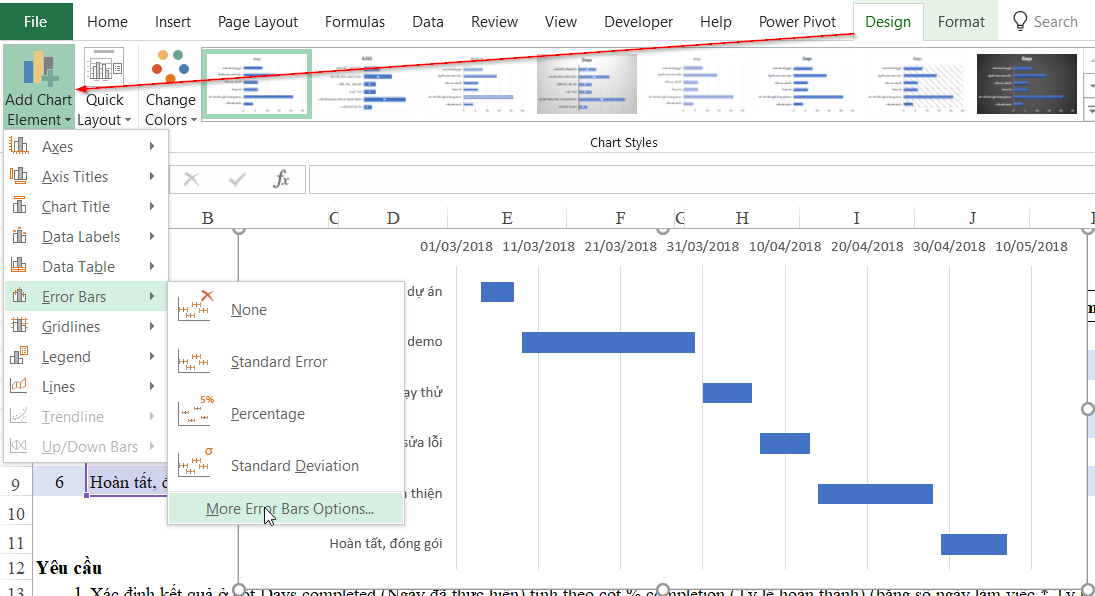

First, select your visible task bars (the Duration series). Navigate to Chart Design > Add Chart Element > Error Bars > More Error Bar Options.
Menu path to add Error Bars element to the chart
In the dialogue box that appears, ensure you are adding error bars based on the Start Date series (or the series that controls the position). We are effectively repurposing this feature to draw a line representing completed work.

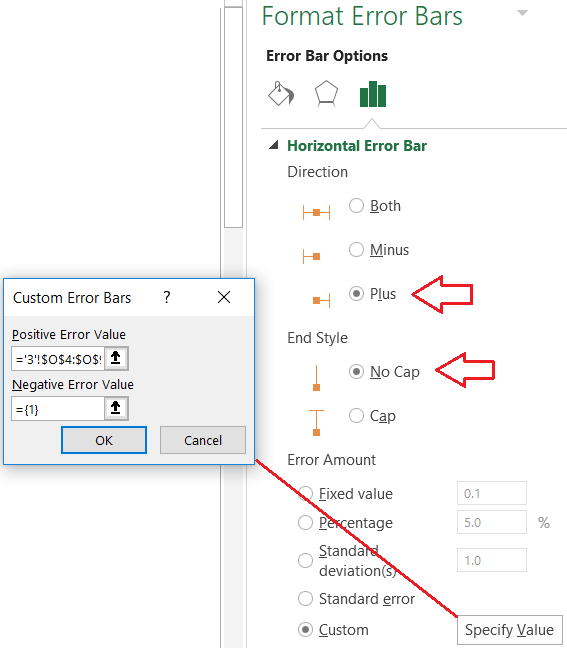

When the Format Error Bars pane opens, configure the following settings:
- Direction: Plus (we want the bar to grow forward).
- End Style: No Cap.
- Error Amount: Select Custom and click Specify Value. Here, select the range of your “Days Completed” column calculated in Section 1.
Configuring error bar direction and amount settings

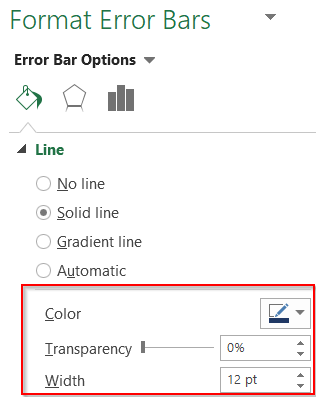

Finally, style these error bars to look like progress indicators. Increase the Width of the line so it is thick enough to be seen inside the main task bar, and choose a contrasting color (like dark green or black).
Adjusting the line width and color of the error bars

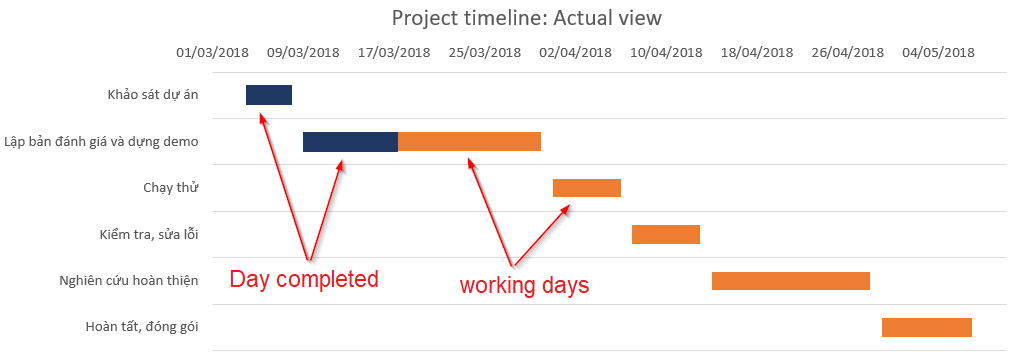

The result is a sophisticated visualization where the main bar represents the total planned time, and the inner bar represents the actual work done. This allows stakeholders to instantly spot lagging tasks.
Final Gantt chart with progress tracking bars overlay
4. Conclusion
Creating a Gantt chart in Excel is a valuable skill that bridges the gap between simple data entry and complex project management. By following these steps, you have transformed a standard stacked bar chart into a powerful tracking tool complete with progress indicators.
This method offers flexibility that rigid software cannot match. You can further customize colors, add conditional formatting, or link the data to other project sheets. Whether you are managing a small team sprint or a large construction timeline, mastering this Excel technique will significantly enhance your reporting capabilities.
References
- Microsoft Support: Present your data in a Gantt chart in Excel.
- TechCommunity: Visualizing project timelines using Stacked Bar Charts.
- Thủ Thuật: Excel Tips and Tricks for Project Management.
